How to Make a Gantt Chart in Excel

By Diana Ramos | March 4, 2019 (updated October 27, 2025)

You can create a Gantt chart in Excel by manually inputting your project data and inserting a chart or by using a prebuilt template. Both options provide a visual representation of your project tasks and their durations so that you can easily track your project progress.

Included in this article, you’ll find the following:

How to Make a Gantt Chart in Excel With a Template

To create a Gantt chart in Excel, download a Gantt chart template from this page, and follow the steps below. This step-by-step guide provides details on how to open the template, enter your project-specific data, and add color-coded duration bars for each task.

Learn about Gantt chart essentials, including what a Gantt chart is, how to use one for project management, and what are the different types.

  1. Download the simple Gantt chart template.

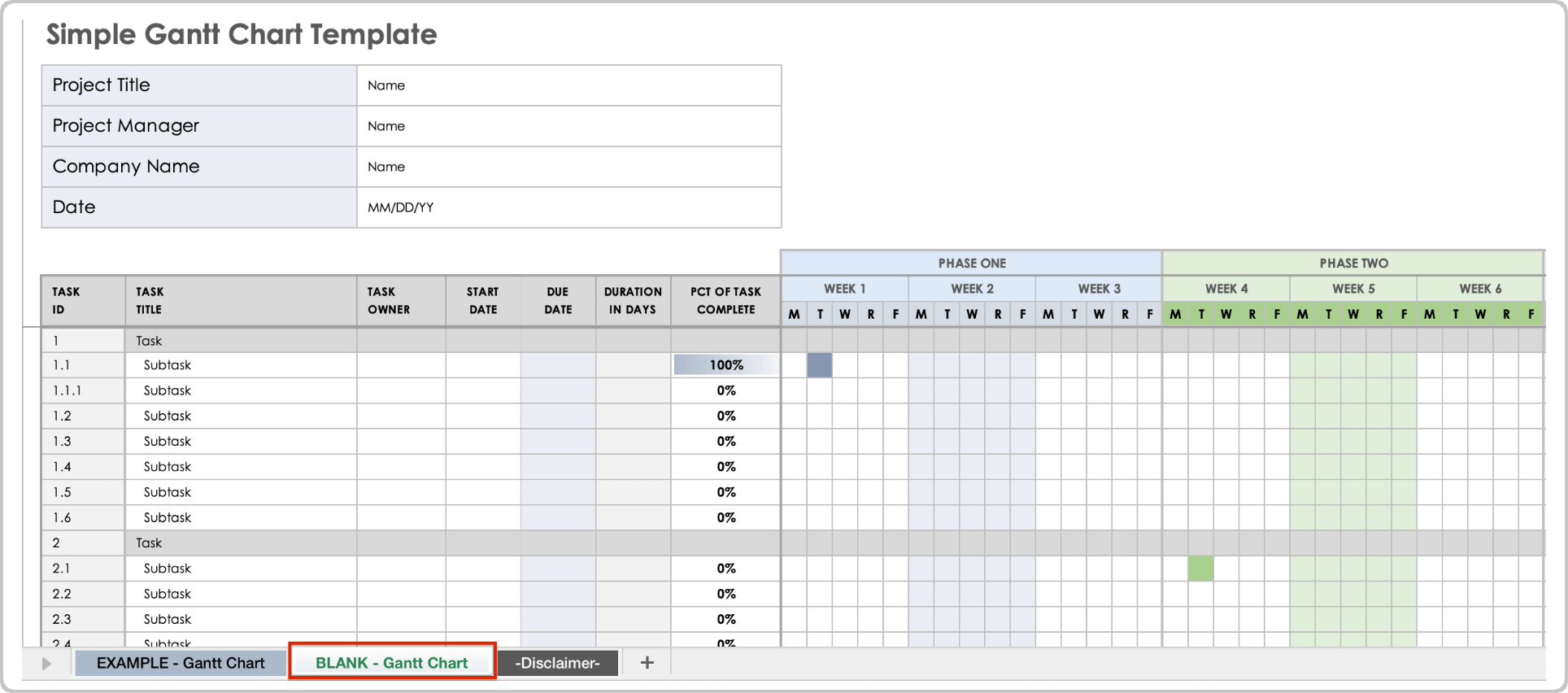

  2. Open the blank template by clicking the BLANK - Gantt Chart tab at the bottom of the worksheet.

    Simple Gantt Chart Template Open Blank Tab

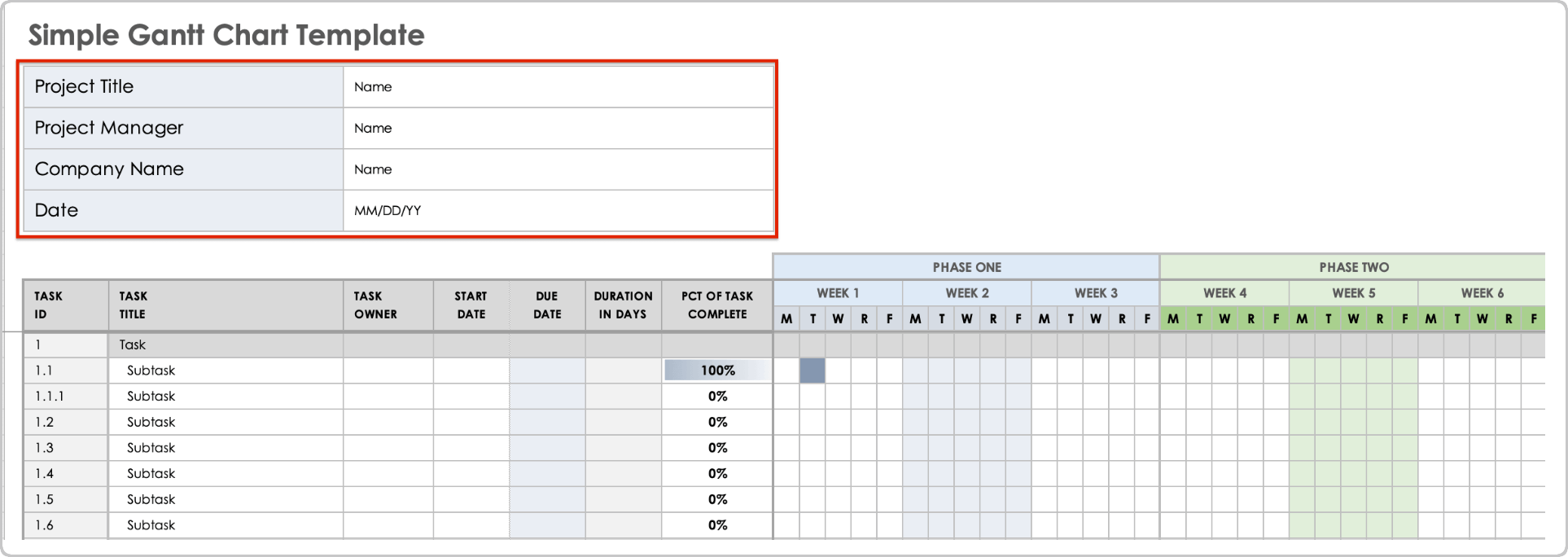

  3. Enter project details in the Project Title, Project Manager, Company Name, and Date fields.

    Simple Gantt Chart Template Enter Project Details

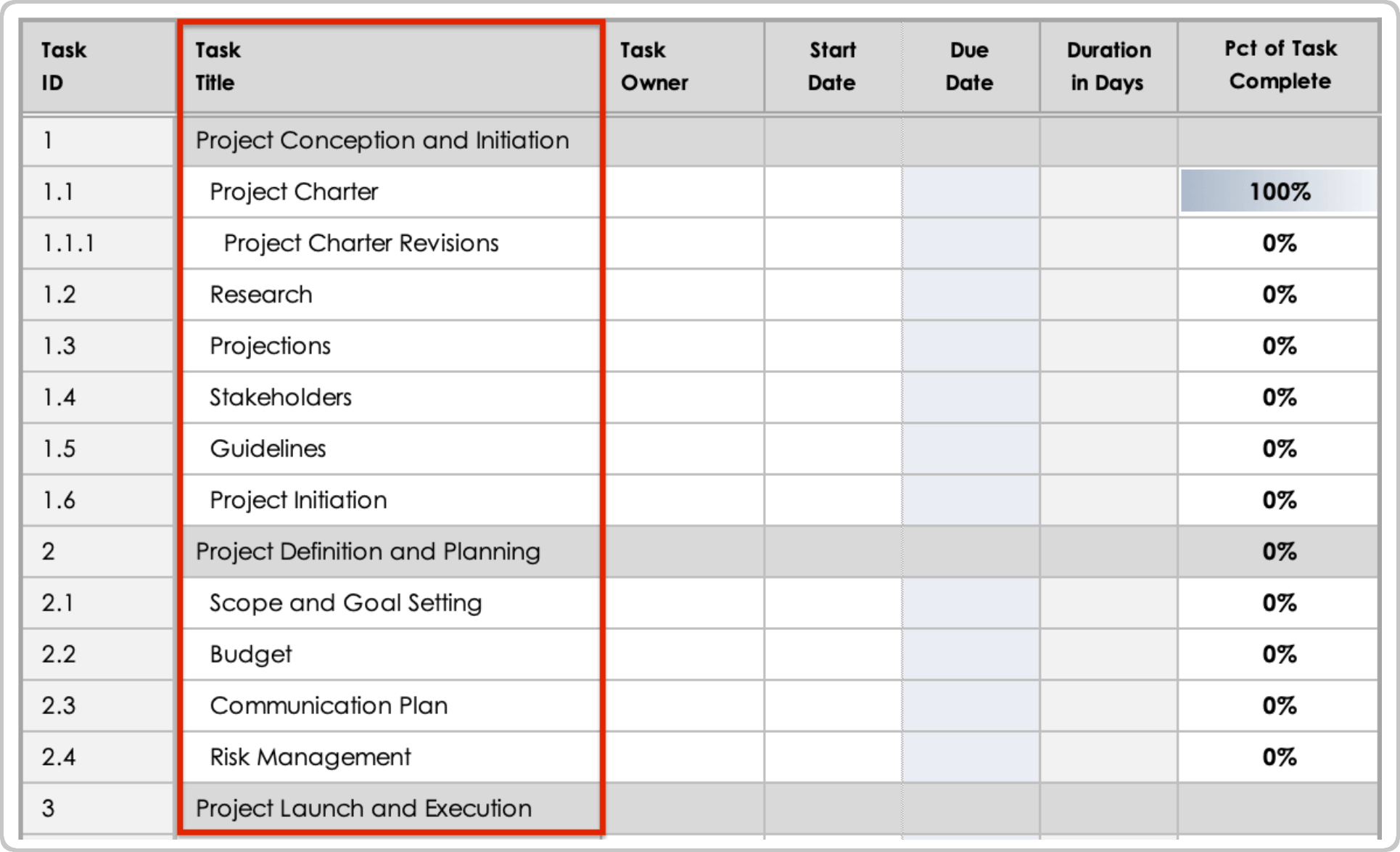

  4. To create your task list, enter each of the project tasks in the Task Title column. Delete or add rows as needed.

    Simple Gantt Chart Template Create Task List

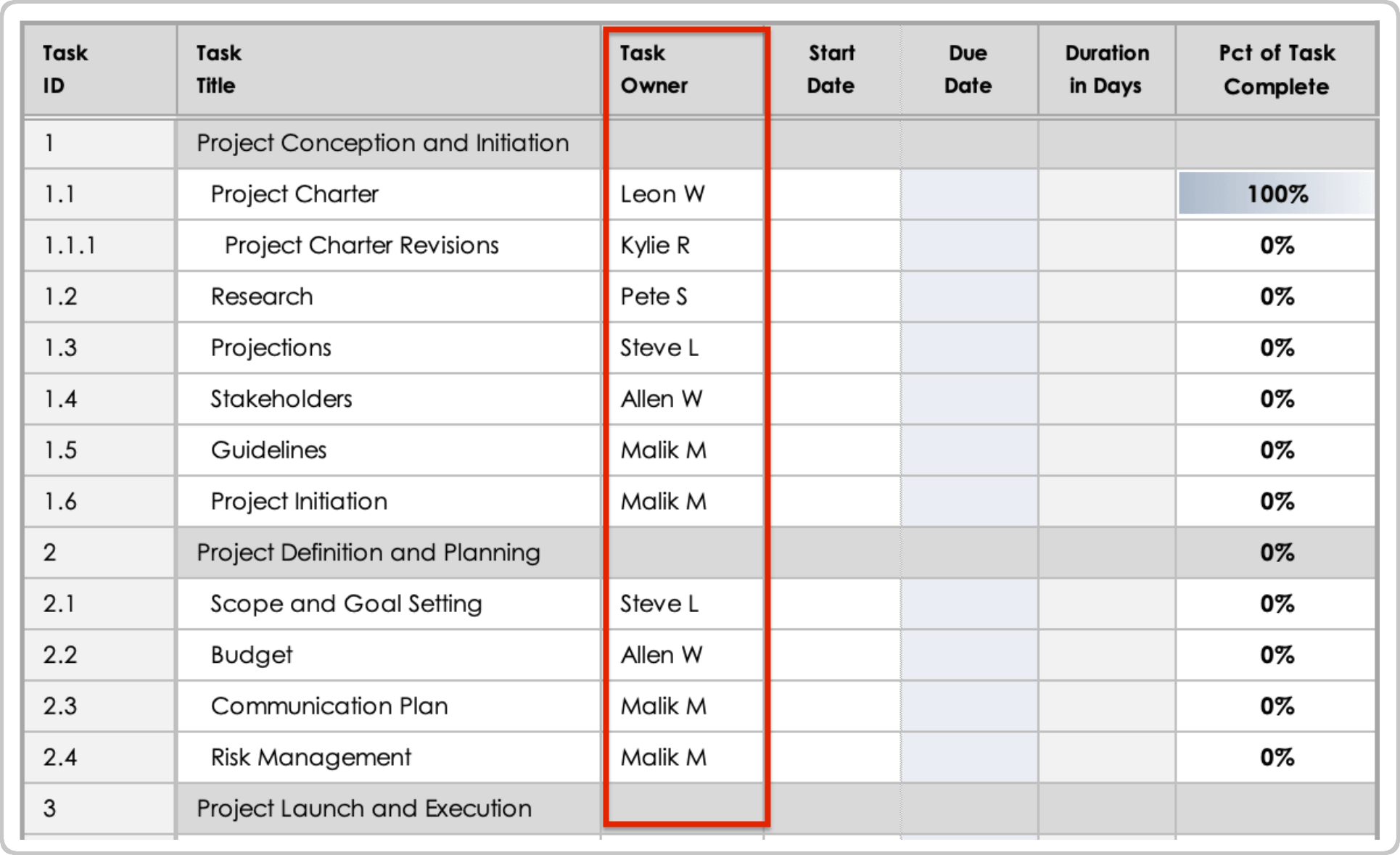

  5. Assign owners to each task by listing the names in the Task Owner column.

    Simple Gantt Chart Template Enter Task Owner

  6. Enter the start and end date for each task in the Start Date and Due Date columns.

    Simple Gantt Chart Template Enter Start and Due Dates

    The Duration in Days column will automatically calculate based on the start and end dates you enter.

    Simple Gantt Chart Template Duration in Days

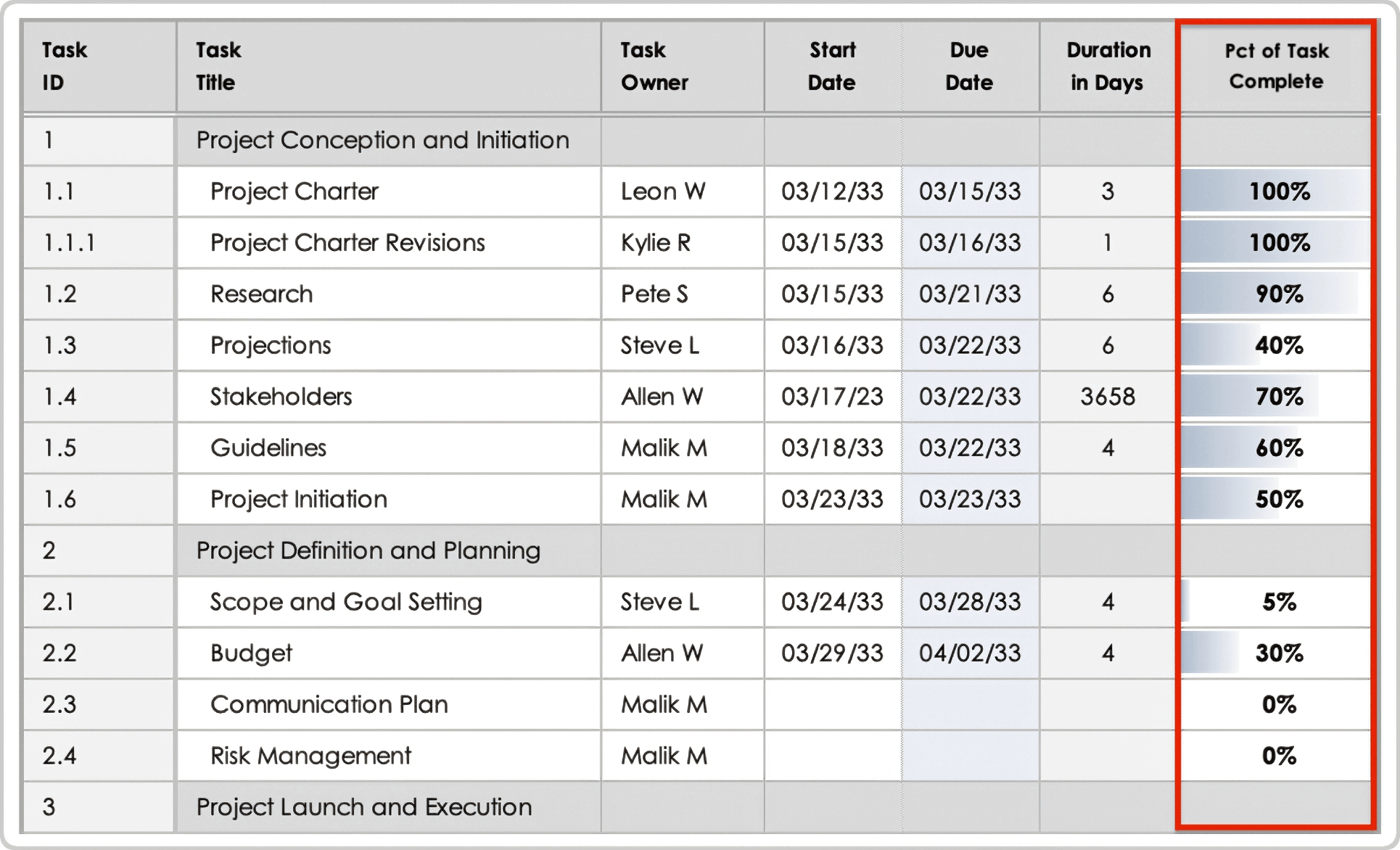

  7. Enter the completion percentage for each task in the Pct of Task Complete column. The cell’s color gradient will change based on the percentage you enter.

    Simple Gantt Chart Template PCT of Task Complete

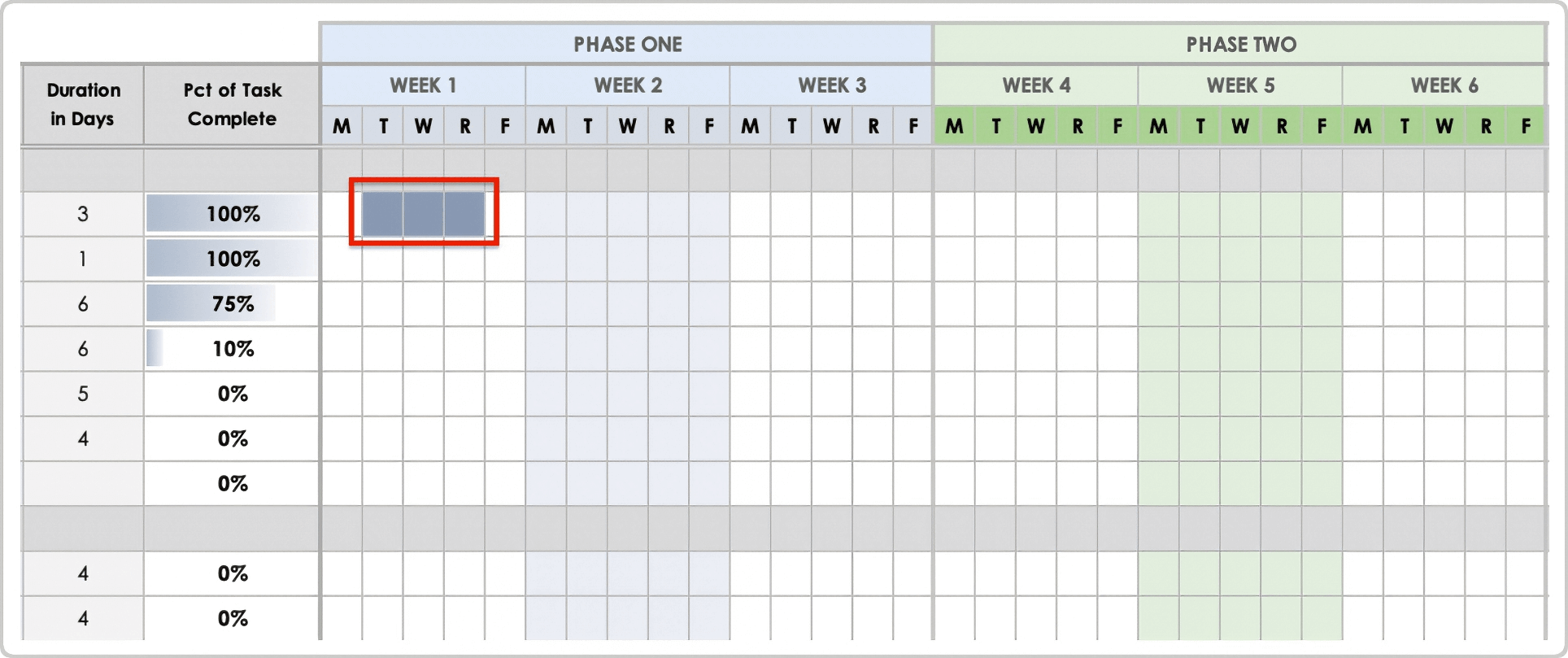

  8. To create graphical duration bars on the Gantt chart, click the pre-filled cell in the Phase One section of the first task. Drag it across the columns to match the duration in days.

    Simple Gantt Chart Template Gantt Chart Duration Bars

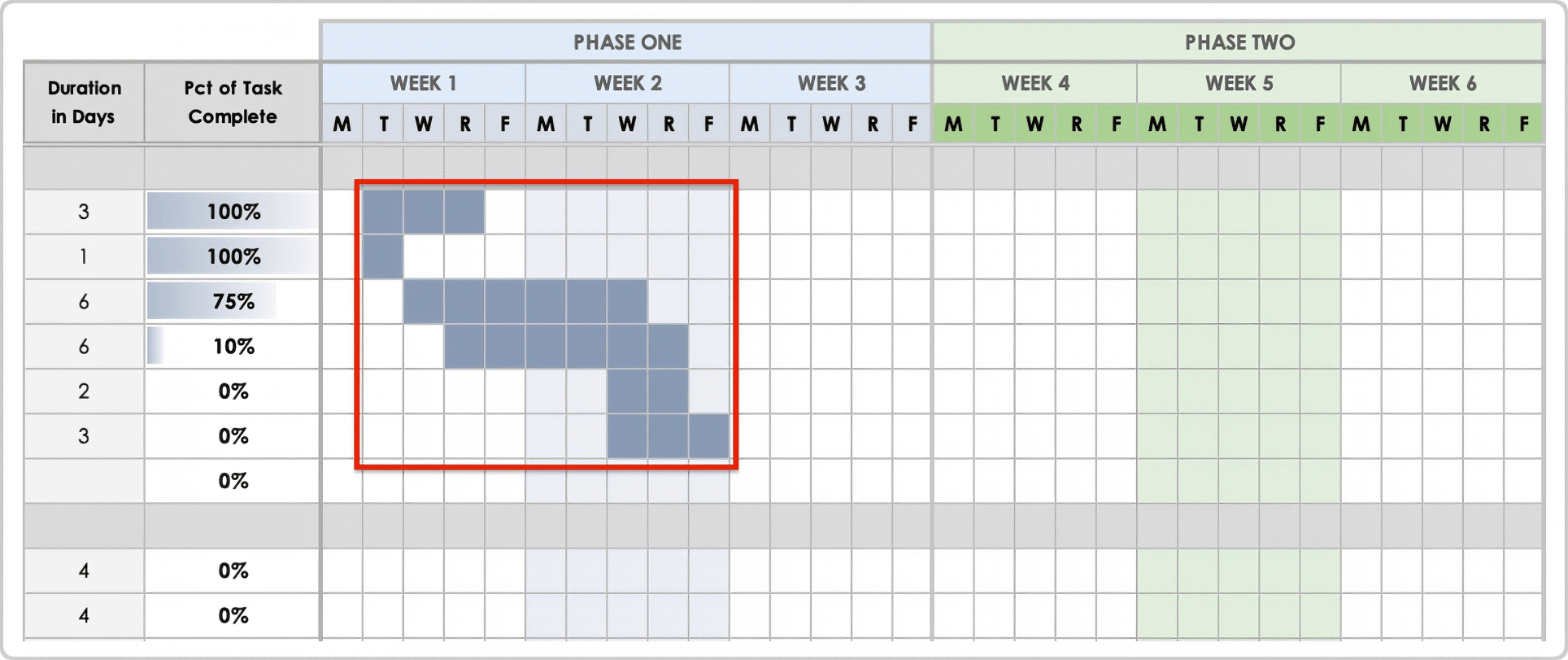

    Continue adding duration bars by clicking a prefilled cell. Then right-click, copy the pre-filled cell, and paste it into a cell of the second task. Click and drag it to match the duration in days.

    Simple Gantt Chart Template Duration Bars Continued

Check out this collection of free Gantt chart templates in Excel, including a 12-month template and one with dependencies.

How to Build a Gantt Chart in Excel

Build a Gantt chart in Excel during the project planning phase to set the schedule and ensure the project stays on track. Follow these steps to create a Gantt chart with custom data, automated calculations, and duration bars to easily visualize your project’s progress.

  1. To create a new spreadsheet, open Excel and click New > Blank workbook.

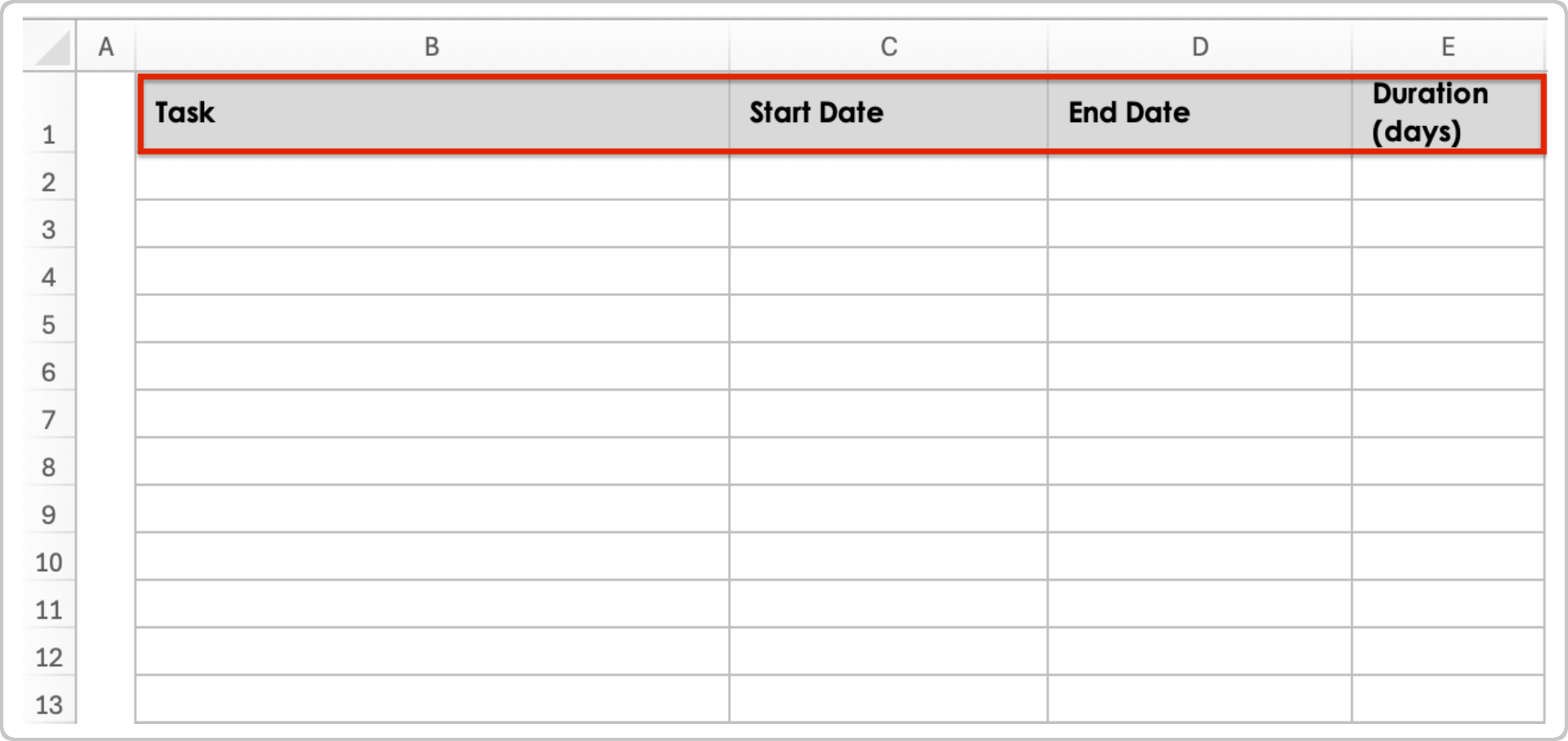

  2. Create the following column headings for your data set: Task, Start Date, End Date, and Duration (days).

    How To Build a Gantt Chart in Excel Create Column Headings

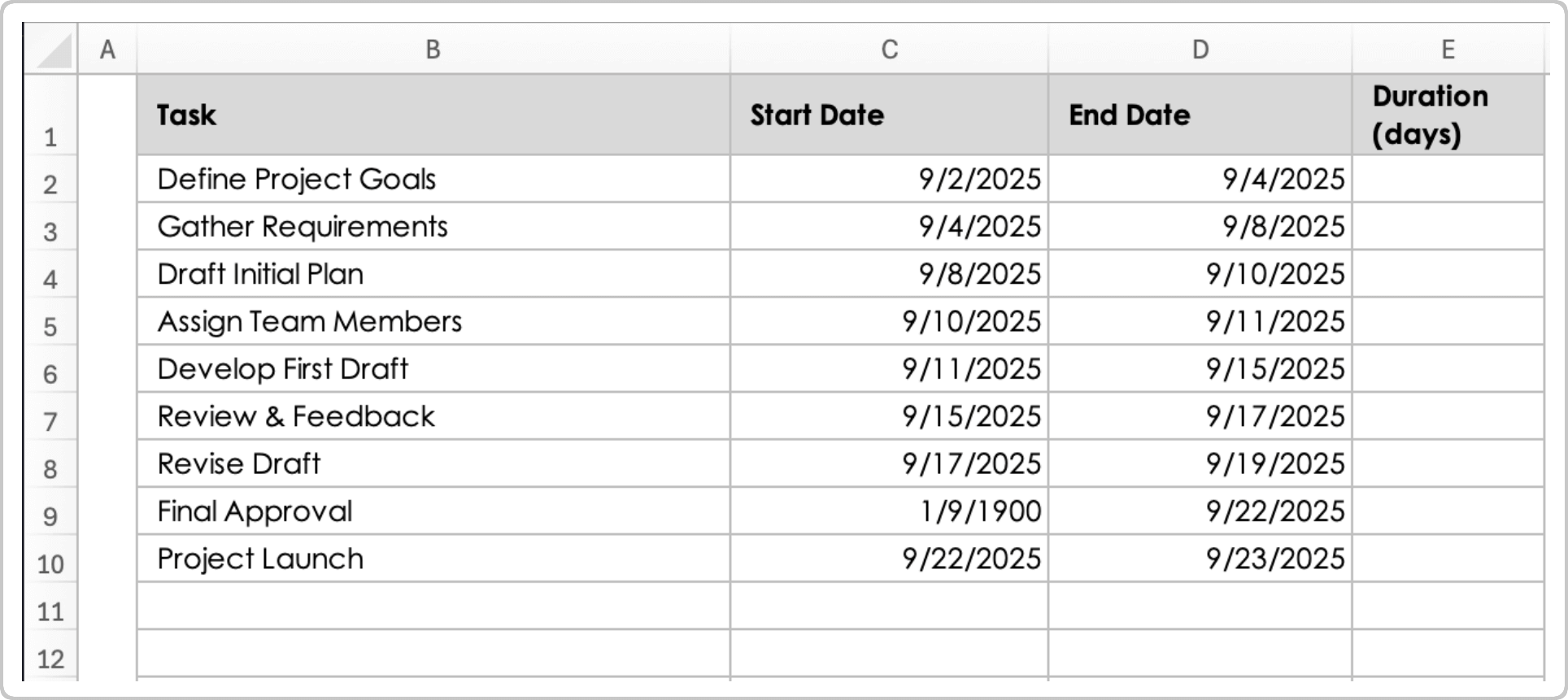

  3. Enter project data, including task names and start and end dates.

    How To Build a Gantt Chart in Excel Enter Project Data

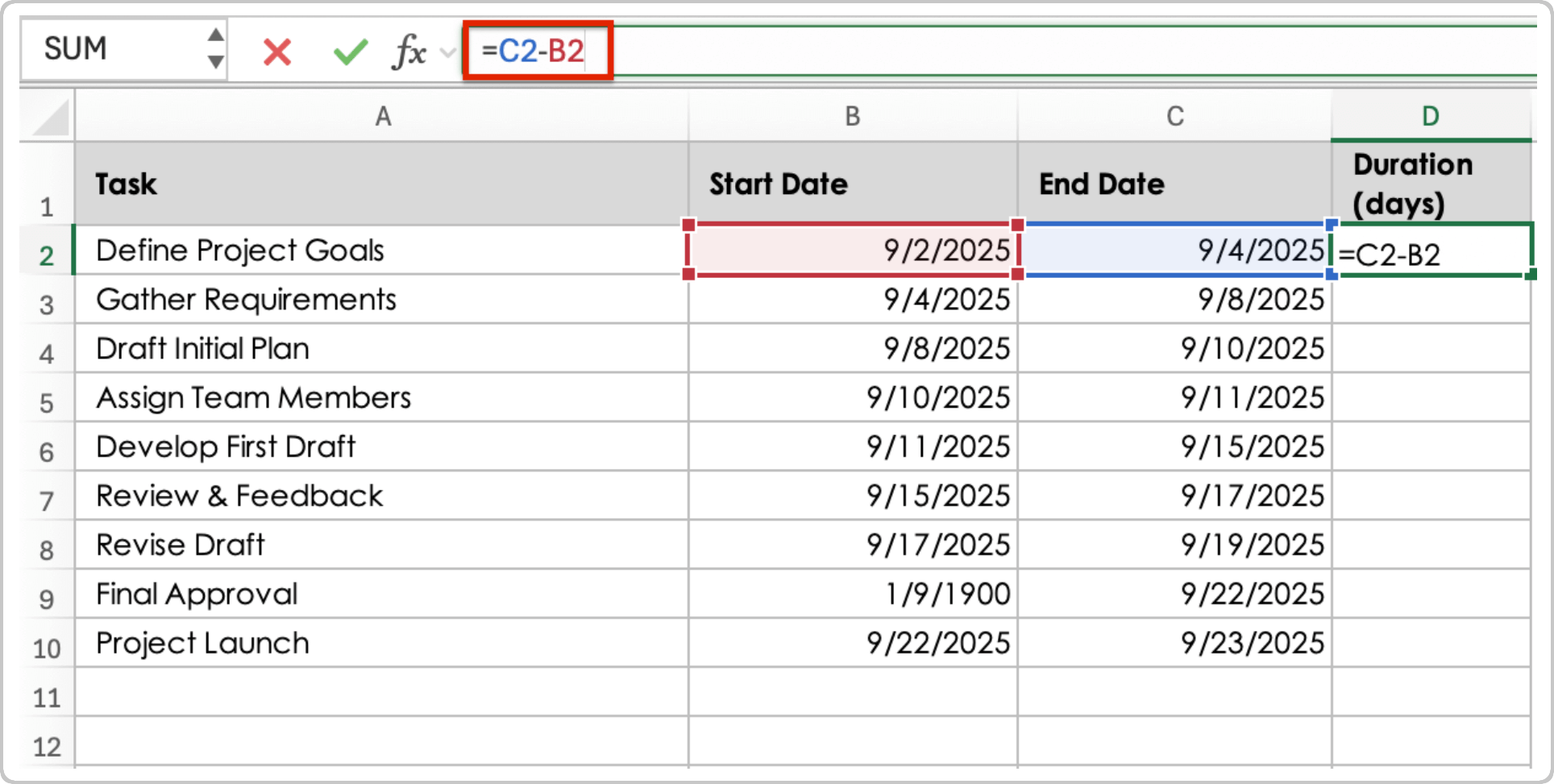

  4. Create a formula to automatically calculate the duration for each task. To do so, enter a formula that subtracts the start date from the end date. In the example below, the formula is =C2-B2.

    How To Build a Gantt Chart in Excel Enter Duration Formula

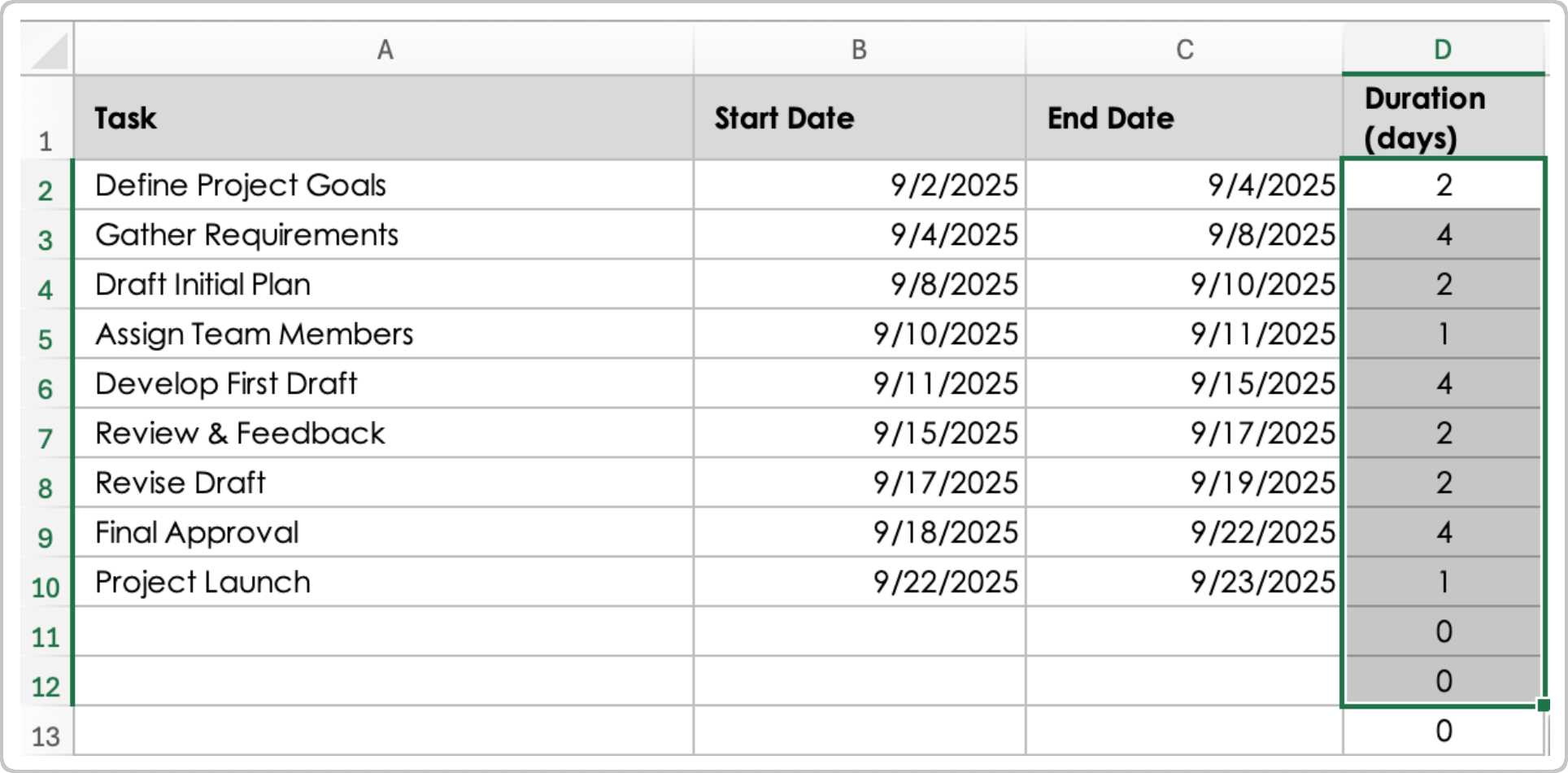

    Click and drag the formula so that it applies to all rows.

    How To Build a Gantt Chart in Excel Drag Duration Formula

  5. To format the Start Date column, highlight the column and right-click. Click Format Cells. Under the Number tab, click General, then OK.

    How To Build a Gantt Chart in Excel Format Start Date Column

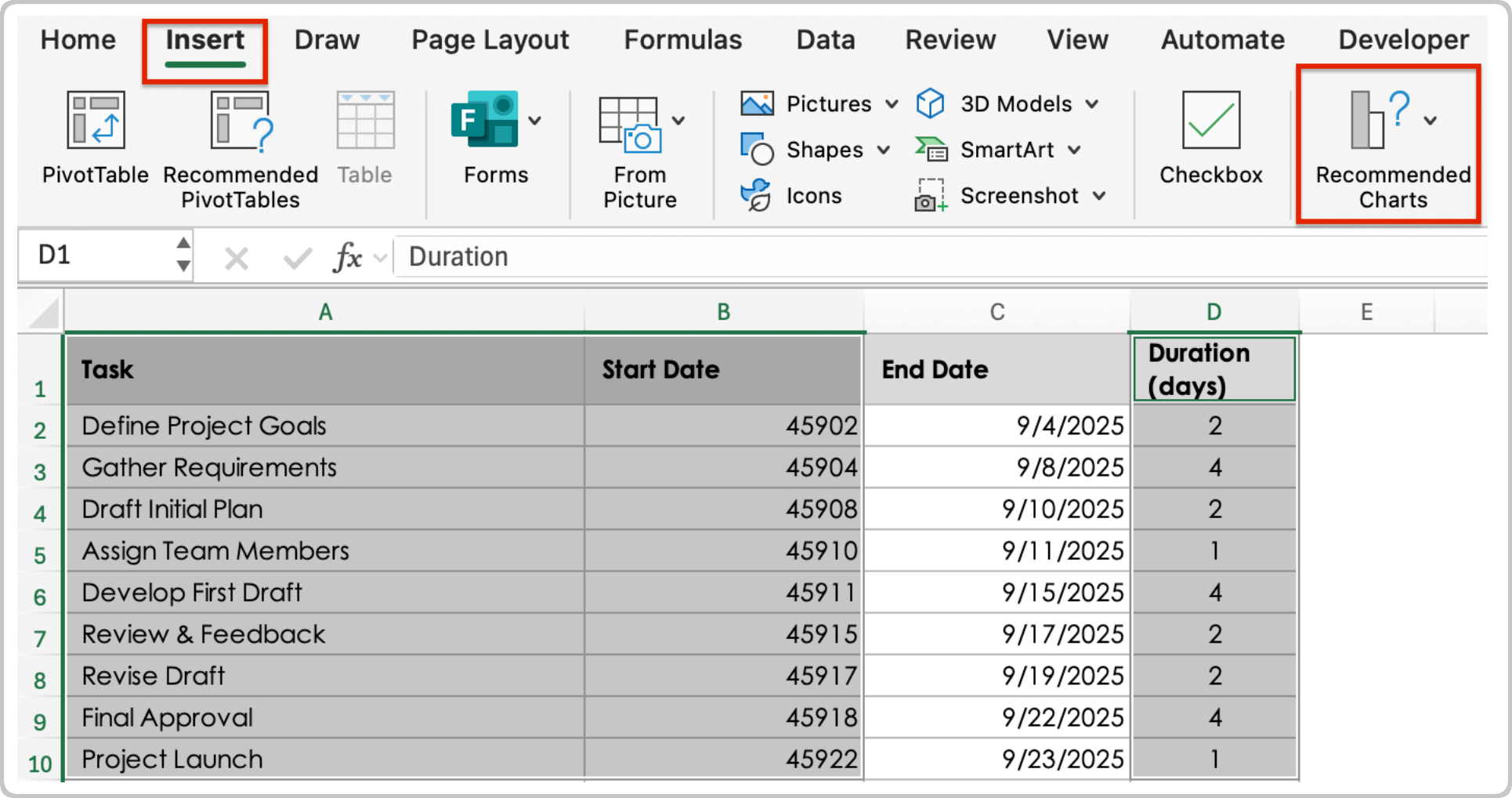

  6. Insert a stacked bar chart by selecting the data range, including the Task, Start Date, and Duration (days) columns. Click Insert > Recommended Charts.

    How To Build a Gantt Chart in Excel Insert Stacked Bar Chart

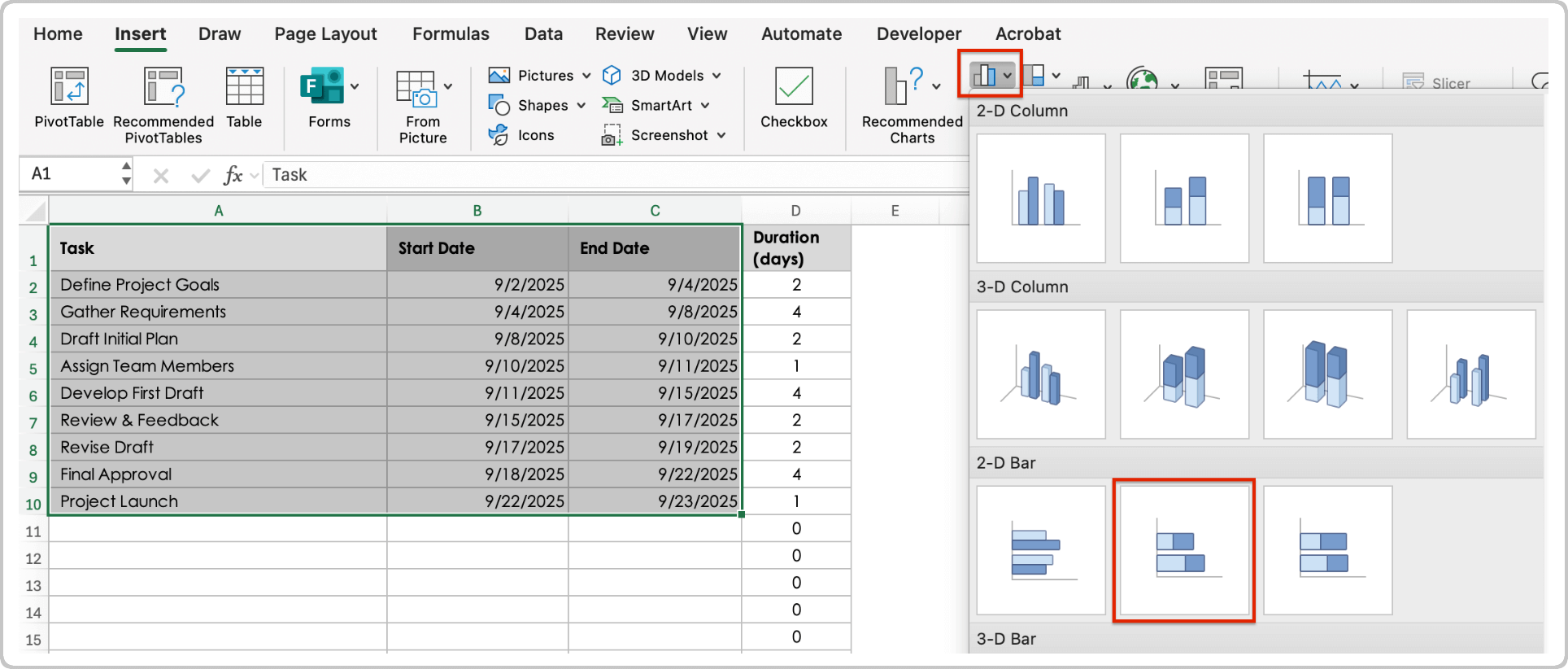

    Click the All Charts tab, followed by Bar > Stacked Bar > OK.

    How To Build a Gantt Chart in Excel Select Stacked Bar Chart

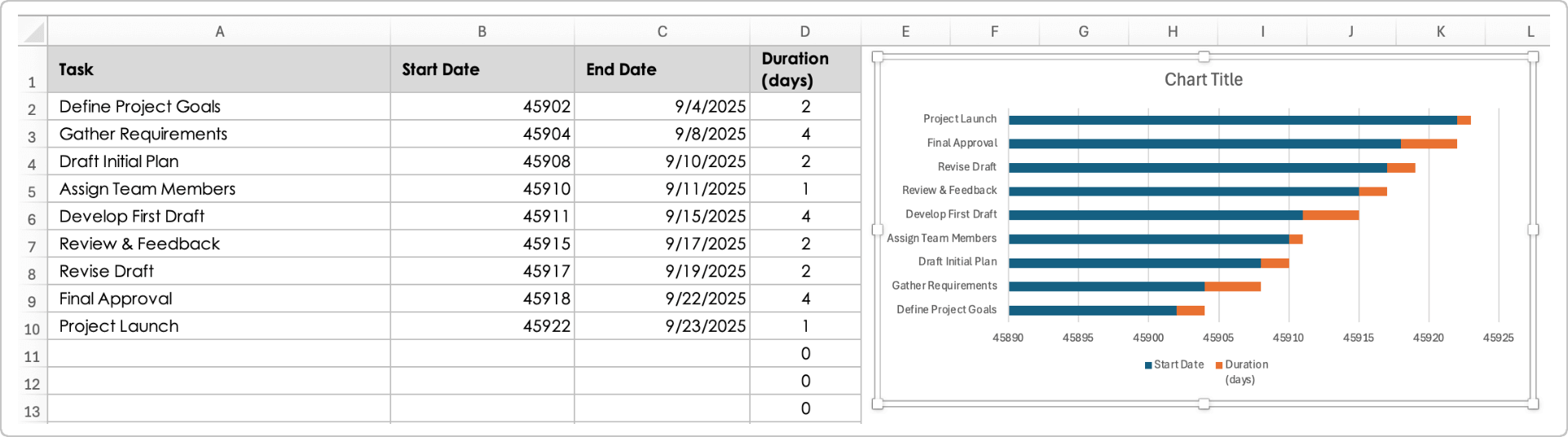

    A bar chart will populate to the right of the table.

    How To Build a Gantt Chart in Excel Bar Chart Populates

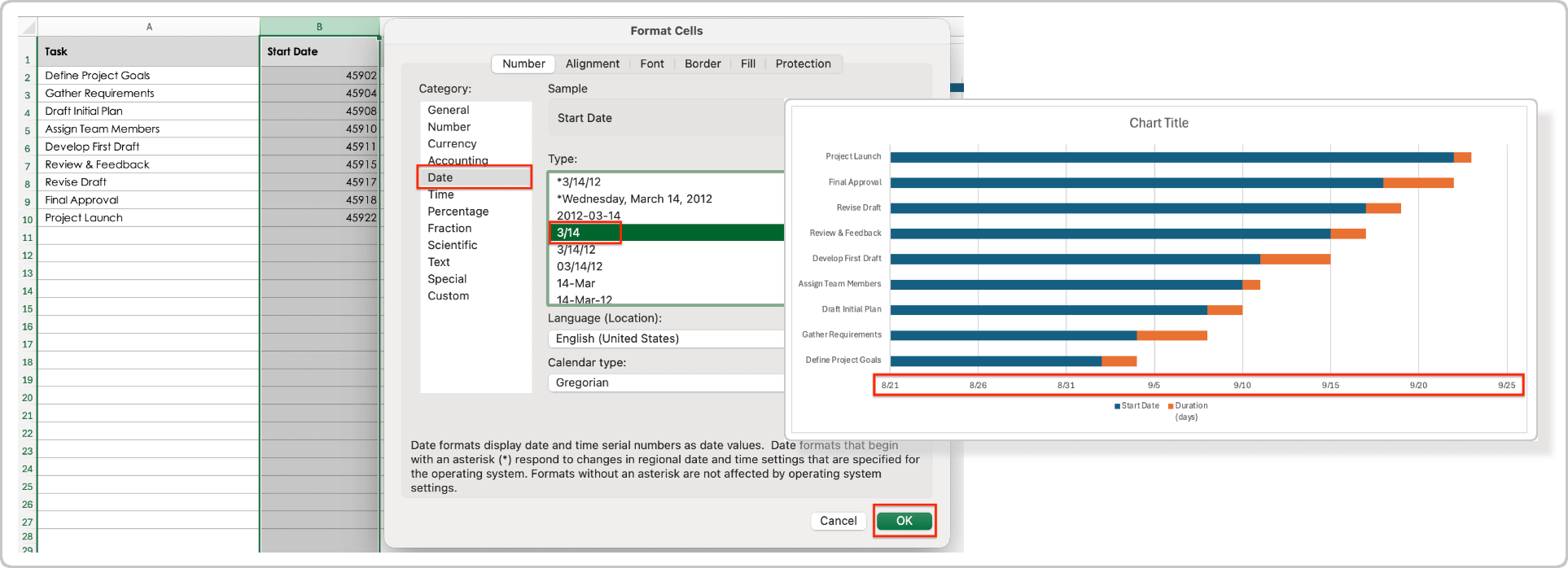

  7. To format the x-axis to list dates, highlight the Start Date column. Right-click and select Format Cells. Then click Date and select a format. Click OK.

    How To Build a Gantt Chart in Excel Format Start Date Column

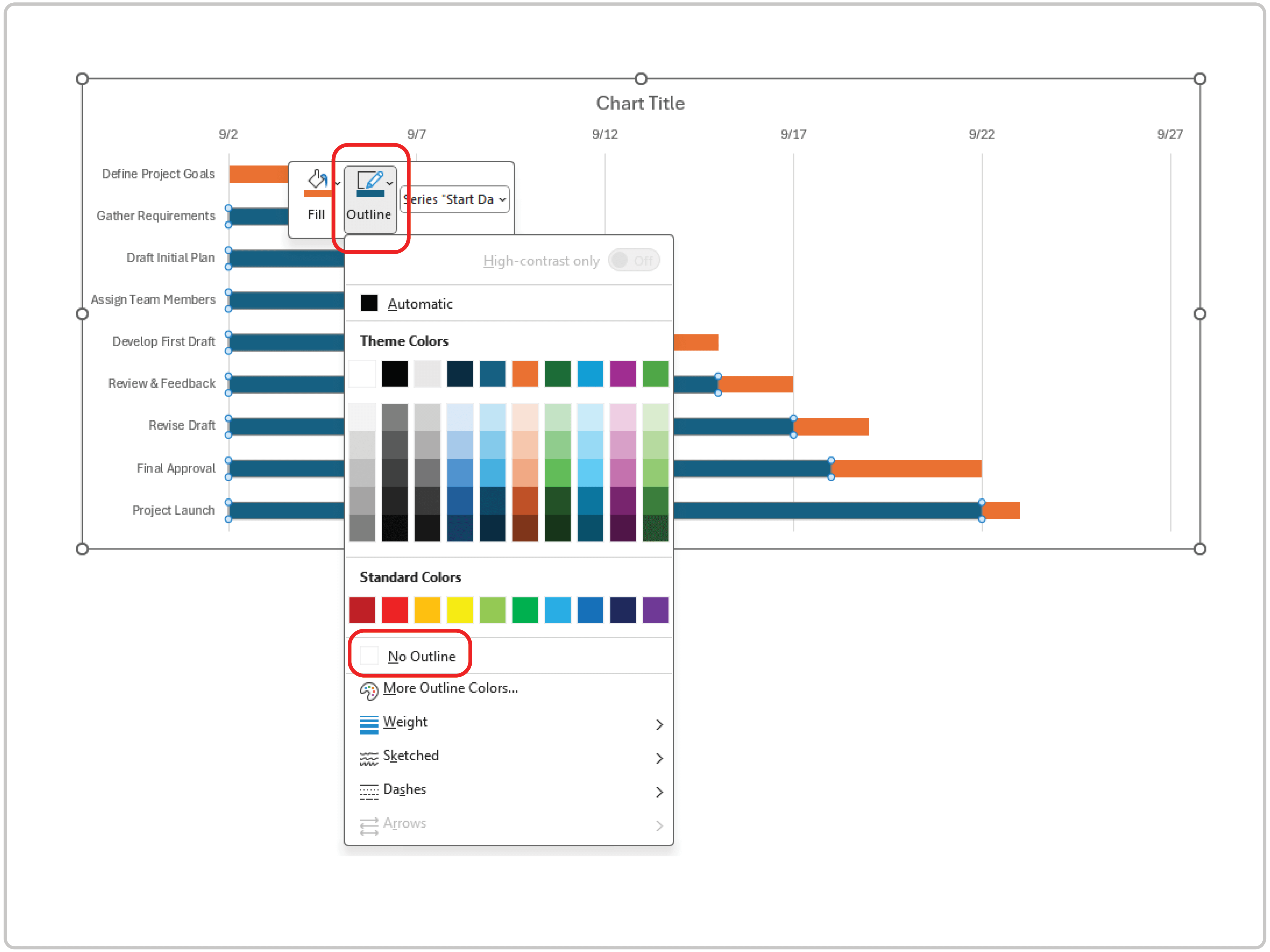

  8. To customize the horizontal bars on the chart, double-click anywhere on the bars. Right-click, click Outline, then click No Outline.

    How To Build a Gantt Chart in Excel Select No Outline

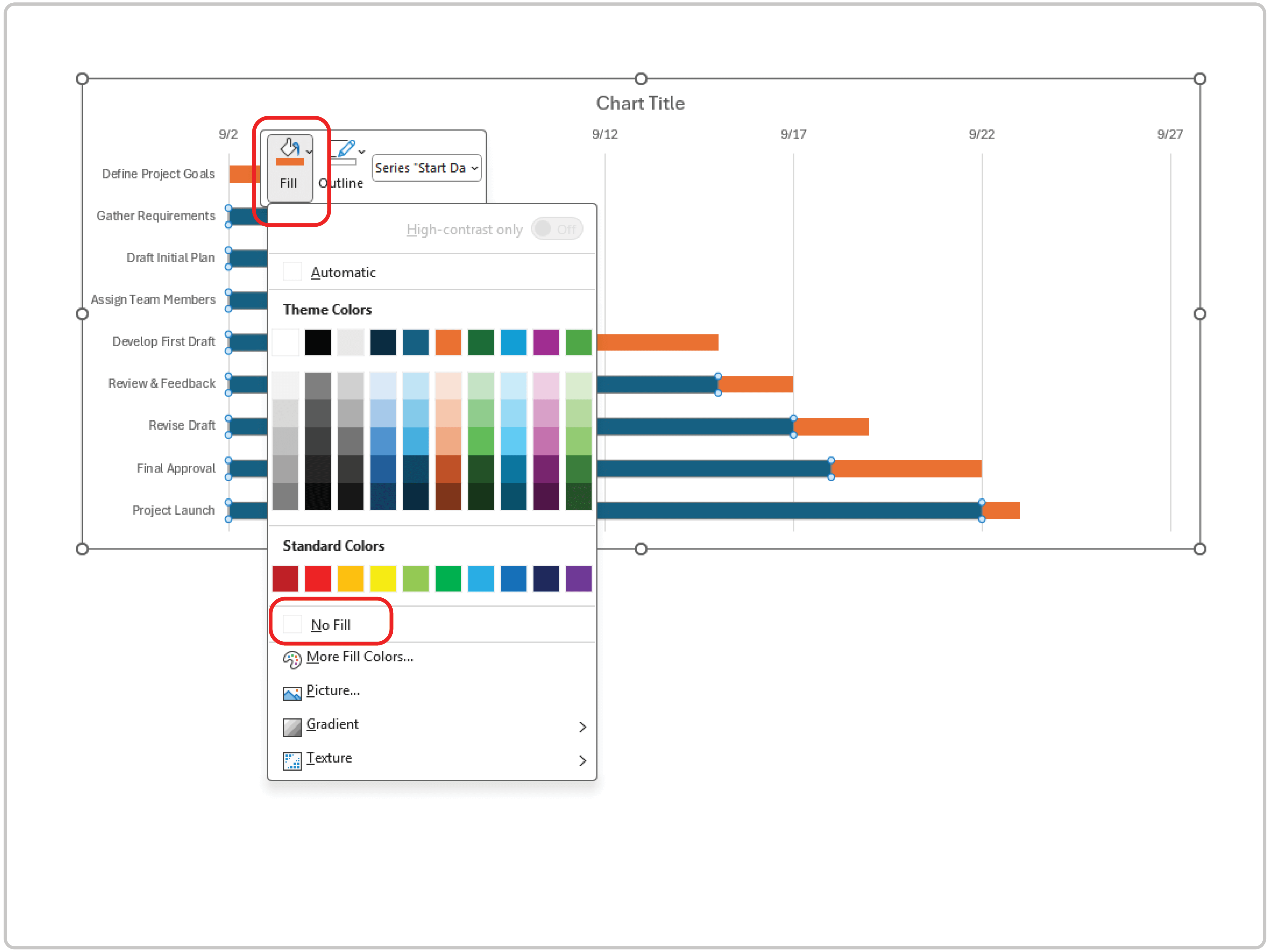

    Double-click anywhere on the blue bars. Right-click, click Fill, then No Fill.

    How To Build a Gantt Chart in Excel Fill Color

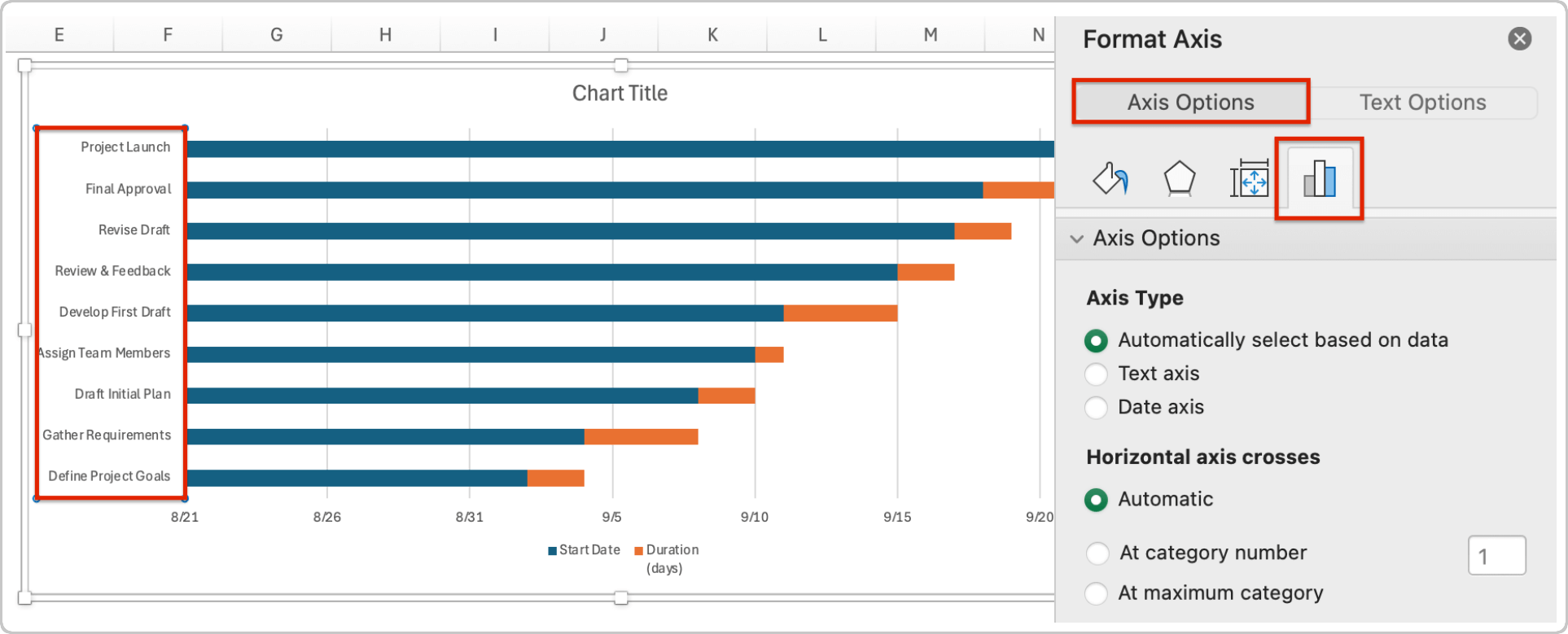

  9. To reverse the task list so that it starts with the first task, double-click the task list inside the chart to open the Format Axis panel. Click the Axis Options icon.

    How To Build a Gantt Chart in Excel Format Axis Options

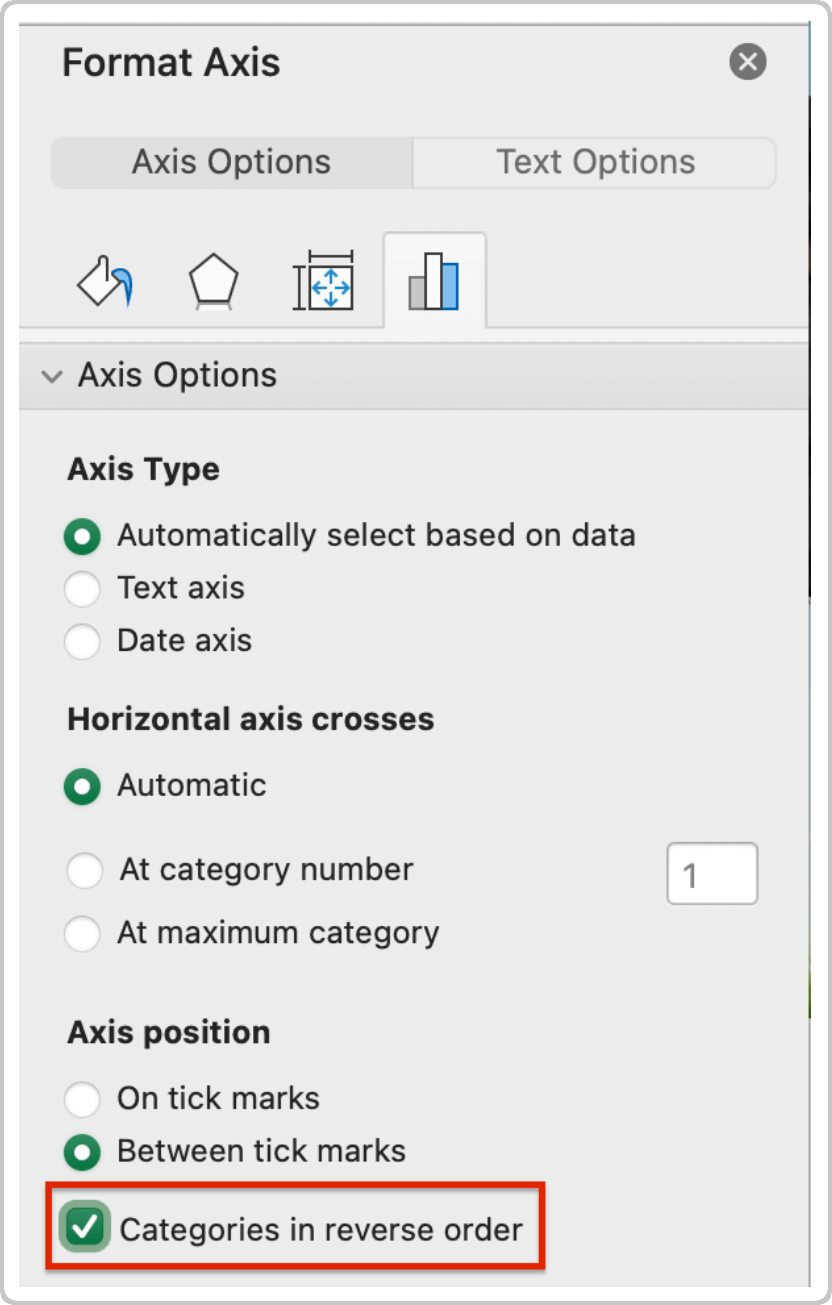

    Under Axis position, select the Categories in reverse order check box.

    How To Build a Gantt Chart in Excel Categories in Reverse Order

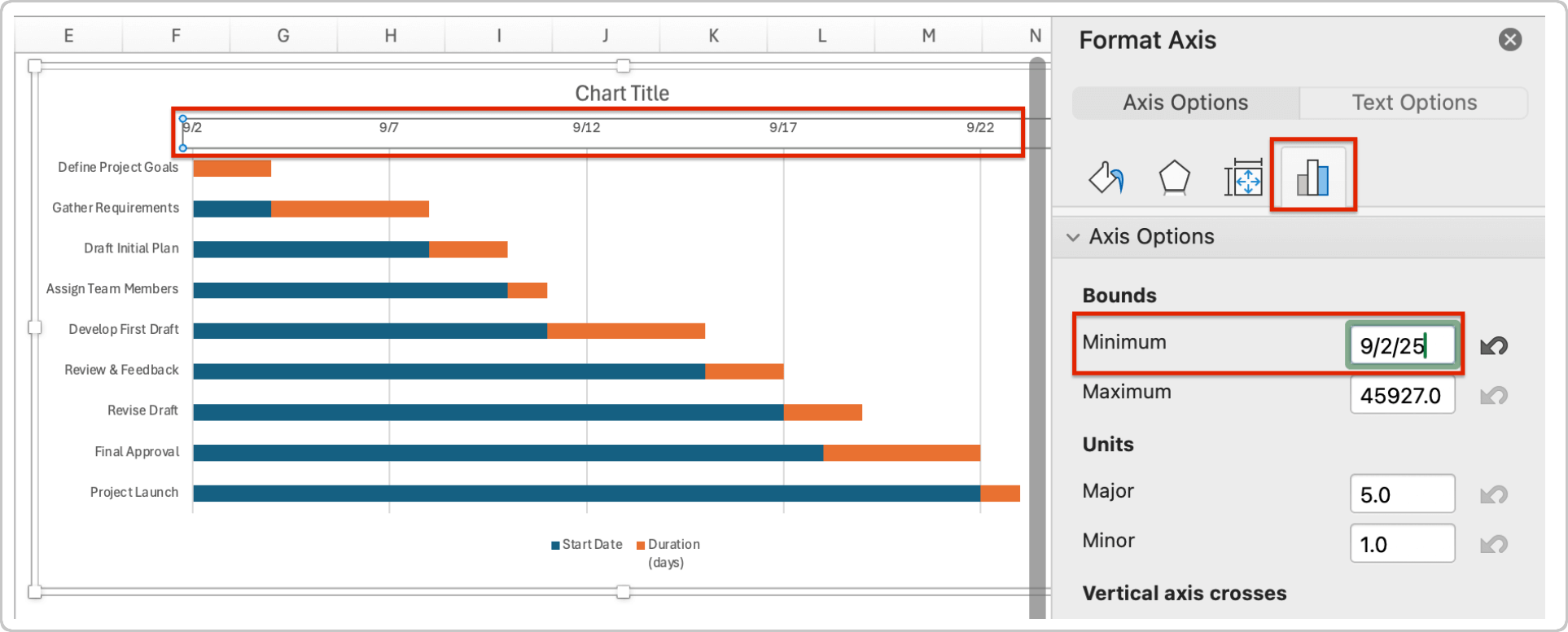

  10. Reposition the duration bars so that they start at the beginning of the chart. Double-click the dates to open the Format Axis panel. Click the Axis Options icon. In the Minimum field, enter the start date of the first task, then press Enter on your keyboard.

    How To Build a Gantt Chart in Excel Format Axis Panel

  11. To remove the legend from the Gantt chart, double-click the legend and press Delete on your keyboard.

    How To Build a Gantt Chart in Excel Delete Chart Legend

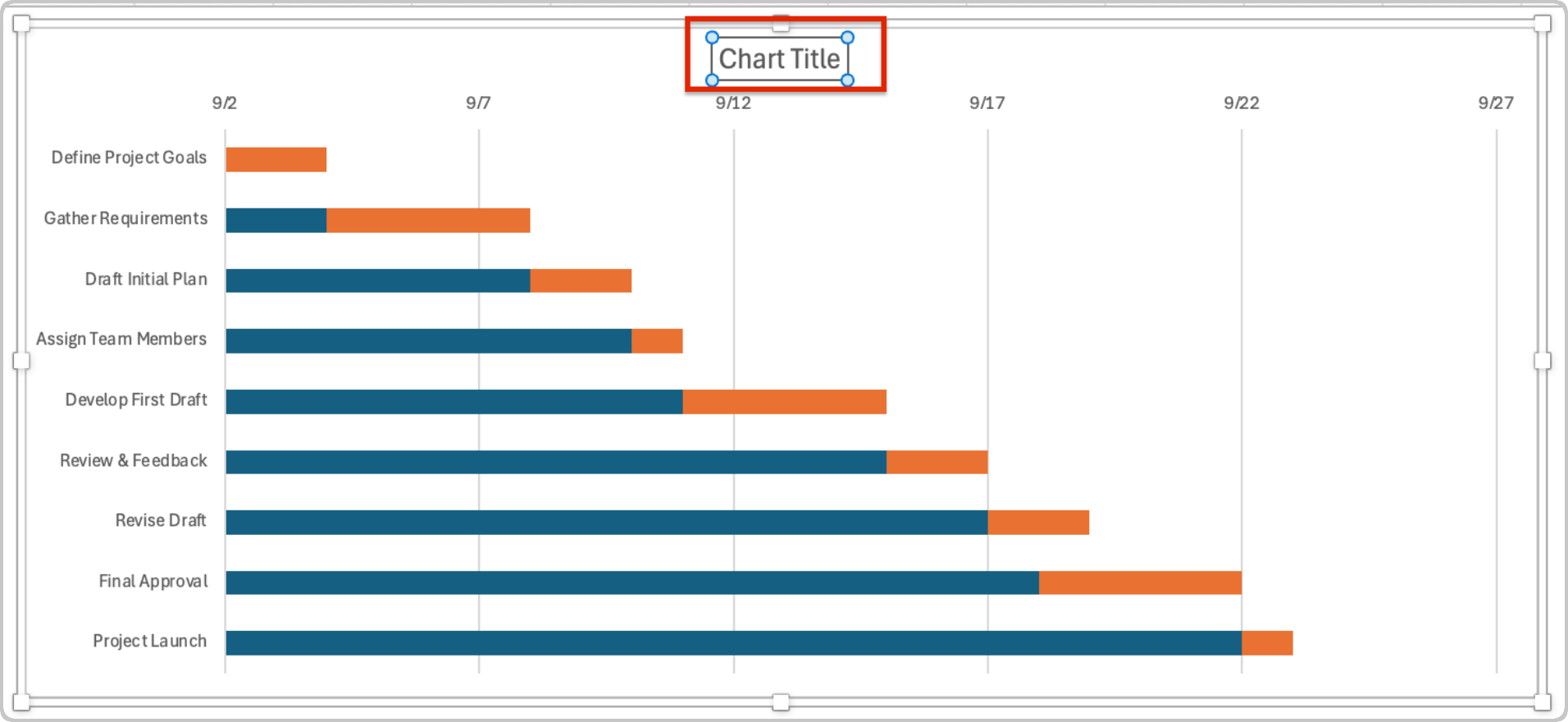

  12. Click on Chart Title and replace the text with your project’s title.

    How To Build a Gantt Chart in Excel Delete Chart Title

Download and customize a variety of monthly Gantt chart templates to easily plan and track your projects on a month-by-month timeline.

Pros and Cons of Making a Gantt Chart in Excel

Creating a Gantt chart in Excel provides basic task tracking and a visual overview of task progress. The benefits include the ability to customize data and store all project information on one screen. However, it is time-consuming to build and difficult to keep current.

A full list of the pros and cons of making a Gantt chart in Excel are below:

Pros

Cons

Customizable Time-consuming setup
Flexible Requires advanced Excel experience
Free Lack of advanced project management features
Ability to store information in one locationBecomes cluttered for large projects
Cloud allows collaboration (OneDrive or SharePoint)Static when not used in the cloud

To simplify scheduling, tracking, and collaboration on your projects, explore the advantages of using online Gantt chart software.
